As an international rail supply chain service provider, Glory Rail is committed to offering flexible, professional, and actionable alternatives when clients face unexpected challenges such as production scheduling issues, material shortages, and administrative delays. This project is a typical example of a 60E1 Rail Replacement for 60E2 Rail, demonstrating Glory Rail’s transition from a reactive supplier to a proactive project partner. By successfully substituting 60E2 with 60E1, using SS material for the initial order, and subsequently incorporating R260 in mixed shipments, we ultimately achieved full delivery after a four-month delay. This helped our Taiwanese client retain an order from a Philippine shipyard and earn the trust of the end customer.
Project Background
Customer Type: Taiwanese Trading & Engineering Company
End User: Shipyard in the Philippines
Original Requirement:
- 131 pcs of 60E2 rail × 11.69 meters

- 131 sets of four-hole fishplates
- 992 sets of rail clamps with M20 bolts

Loading Port: Tianjin, China
Destination Port: Manila North Harbor, Philippines
Original Delivery Schedule: End of 2025
Actual Shipment Date: February 2026
The rails were intended for a heavy-duty rail system within a shipyard facility, where reliability and timely delivery were essential for maintaining the project schedule.
Challenge 1: No Production Schedule for 60E2 Rail
The first obstacle appeared shortly after order confirmation.
The customer specifically requested 60E2 rail. However, the mill had no production plan for this profile within the required timeframe, making it impossible to meet the project schedule.
Rather than waiting indefinitely, Glory Rail proposed a practical rail replacement solution.
Solution: 60E1 Rail as an Alternative

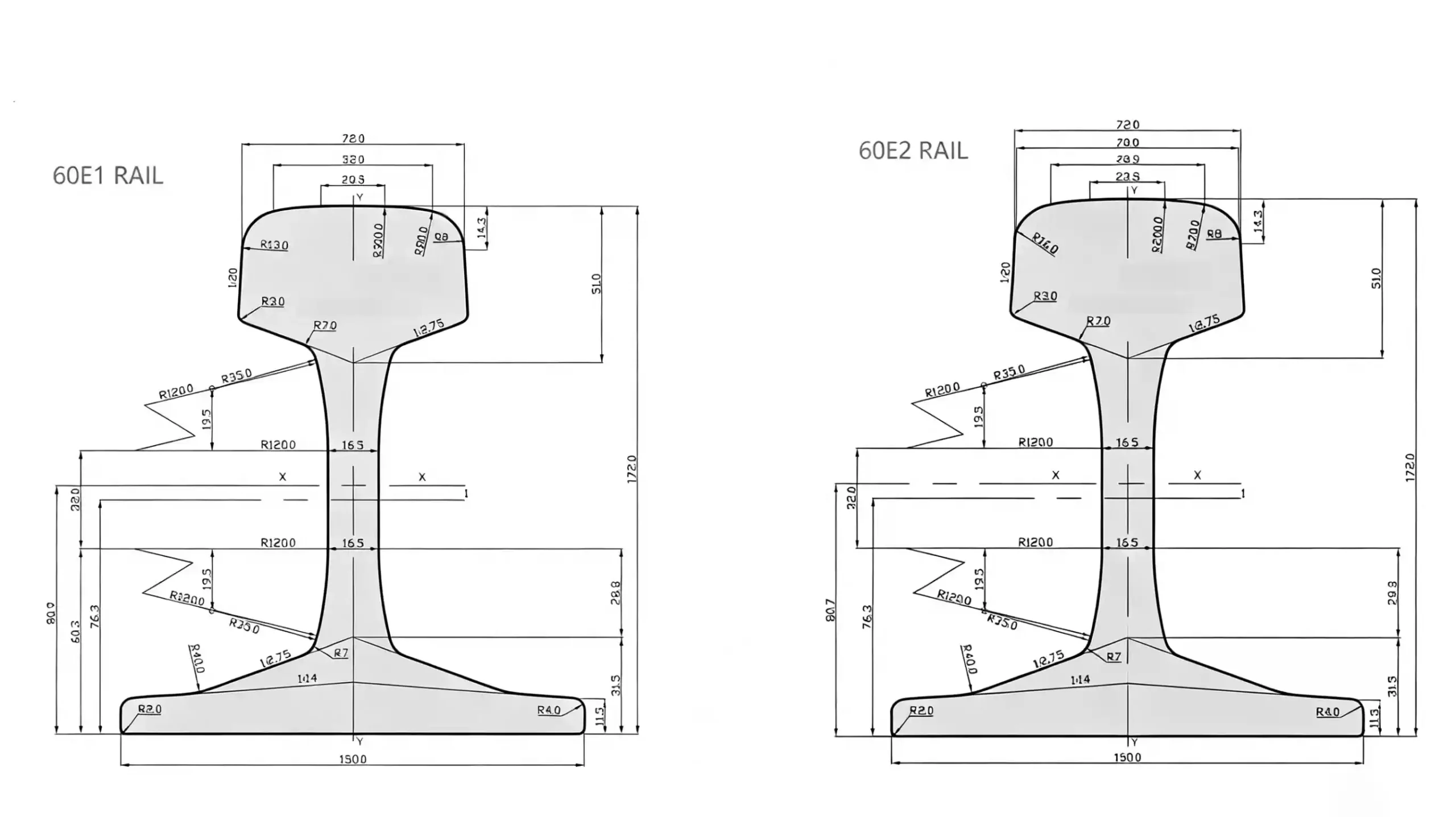

Our engineering team prepared detailed comparisons between 60E1 rail and 60E2 rail, including:
- Rail profile dimensions
- Head geometry comparison
- Mechanical properties
- Load-bearing capability
- Application suitability
An online technical meeting was organized with the customer to review the data and discuss potential risks.
After evaluating the information, the customer confirmed that the 60E1 Rail Replacement for 60E2 Rail could fully satisfy the operational requirements of the shipyard track system.
The customer subsequently issued formal approval for the substitution, allowing the project to move forward without waiting for future 60E2 production.

Challenge 2: Limited Material Availability
Once the rail profile issue was resolved, another challenge emerged.
The customer preferred R260 material. However, only SS-grade rails were immediately available in stock, while R260 rails required additional lead time.
At this stage, delaying shipment could have jeopardized the entire project.
Solution: Transparent Material Comparison

Instead of hiding inventory limitations, Glory Rail provided a detailed comparison between SS and R260 rails, covering:
- Hardness
- Wear resistance
- Expected service life
- Typical applications
- Cost-performance considerations
Based on the project timeline, we proposed supplying an initial batch of 31 rails in SS material while securing R260 rails for future requirements.
The customer reviewed the technical data and accepted the proposal, enabling the project to maintain momentum.

Challenge 3: Import Permit Delays in the Philippines
Although the rails were prepared for shipment, the project encountered an unexpected administrative issue.
The end user’s import permit approval process in the Philippines took significantly longer than expected.
As a result, the cargo remained ready but could not be shipped.
Solution: Inventory Management and Continuous Support
To support the customer during the waiting period, Glory Rail:
- Reserved inventory without additional pressure
- Provided regular inventory status updates
- Offered free storage during the permit approval process
- Shared experience regarding common import approval bottlenecks
Rather than becoming frustrated by the delay, the customer appreciated the proactive communication.
In fact, during the permit waiting period, the customer placed an additional order for 93 rails.
Challenge 4: Mixed Material Delivery (SS + R260)
The additional order created a new challenge.
The first 31 rails were supplied in SS material, while the newly ordered 93 rails were available in R260.
The customer was concerned about using mixed materials within the same rail system.
Solution: Standardized Mixed Material Management
Glory Rail prepared a comprehensive mixed-material delivery plan.
Our technical team explained that the primary difference between SS and R260 lies in wear resistance and service life rather than immediate operational performance. For the shipyard application, both materials could operate safely within the same system.
To eliminate confusion during installation, we implemented several control measures:
- Individual rail marking for SS and R260 identification
- Separate material certificates for each grade
- Bilingual documentation in English and Chinese
- Detailed packing lists identifying material ranges
These measures provided complete traceability and gave both the customer and end user confidence in the mixed-material arrangement.
Final Shipment
After the import permit was finally approved, shipment arrangements were completed immediately.

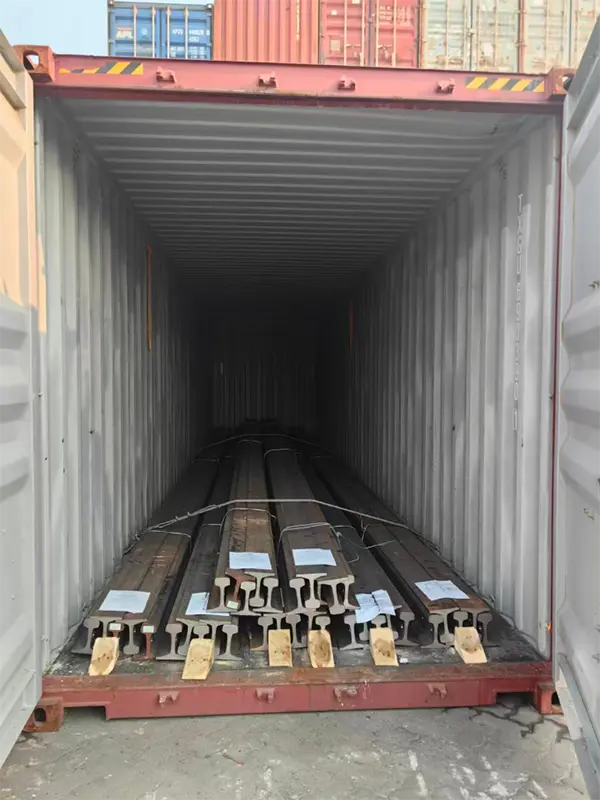

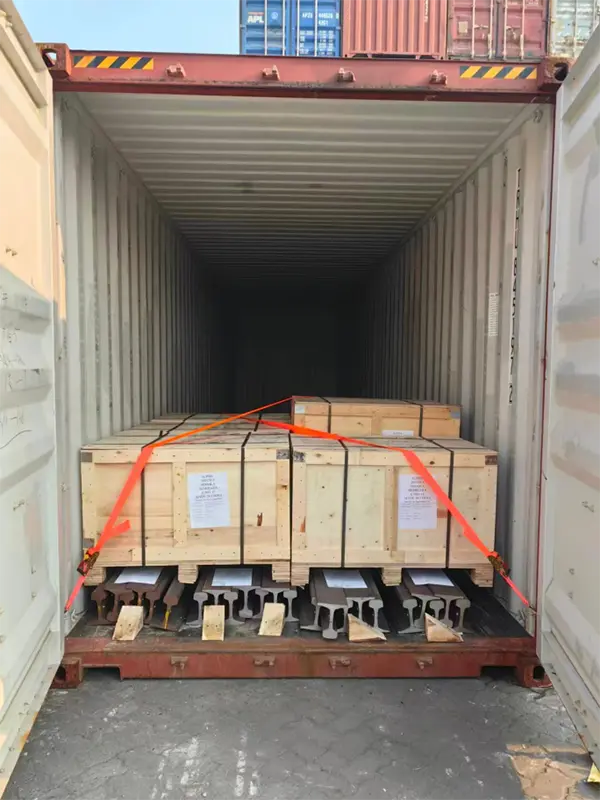

The cargo was loaded at Tianjin Port and shipped to Manila North Harbor with a complete documentation package, including:
- Mill test certificates
- Material certificates
- Rail substitution approval documents
- Mixed-material handling instructions
Within seven days of permit approval, the entire order was successfully dispatched.
Project Results
Order Completion
- 131 rails delivered successfully
- 131 fishplate sets supplied
- 992 rail clamp assemblies delivered

Successful Rail Substitution
The approved 60E1 Rail Replacement for 60E2 Rail enabled the customer to avoid production delays and maintain the project schedule.
Customer Confidence
The customer formally accepted the mixed-material arrangement consisting of:
- 31 pcs SS rail
- 93 pcs R260 rail
Fast Response After Approval
Shipment was completed within seven days after import authorization was granted.
Long-Term Cooperation
Following the project’s completion, the customer indicated willingness to continue adopting Glory Rail’s recommended technical solutions for future Southeast Asian rail projects.
Why This Project Matters
This project demonstrates that successful rail supply is not only about manufacturing rails. It is about solving problems before they become project failures.
Throughout the project, Glory Rail successfully managed:
- Rail profile substitution
- Material shortages
- Inventory planning
- Import permit delays
- Mixed-material deliveries
- Documentation compliance
The successful implementation of the 60E1 Rail Replacement for 60E2 Rail ultimately helped the customer secure its shipyard contract and maintain the trust of the end user.
For international rail projects, unexpected challenges are inevitable. What matters is having a supplier capable of providing practical alternatives, technical guidance, and reliable supply chain support when those challenges arise.
At Glory Rail, every replacement recommendation is supported by technical evidence, every material substitution follows a documented process, and every delivery challenge is approached with a solution-oriented mindset.
